Airfield Construction

Main runway north end rehabilitation

The airport is rehabilitating the north end of the main runway, Runway 16R/34L, in 2026. The project involves:

  • Removing and repaving the top 8 inches of pavement
  • Adding drainage to relocate the drainage system outside of the runway safety area and improve drainage on the northend fo the airfield
  • Replacing in-pavement runway light cans
  • Removal of non-standard Taxiway A2

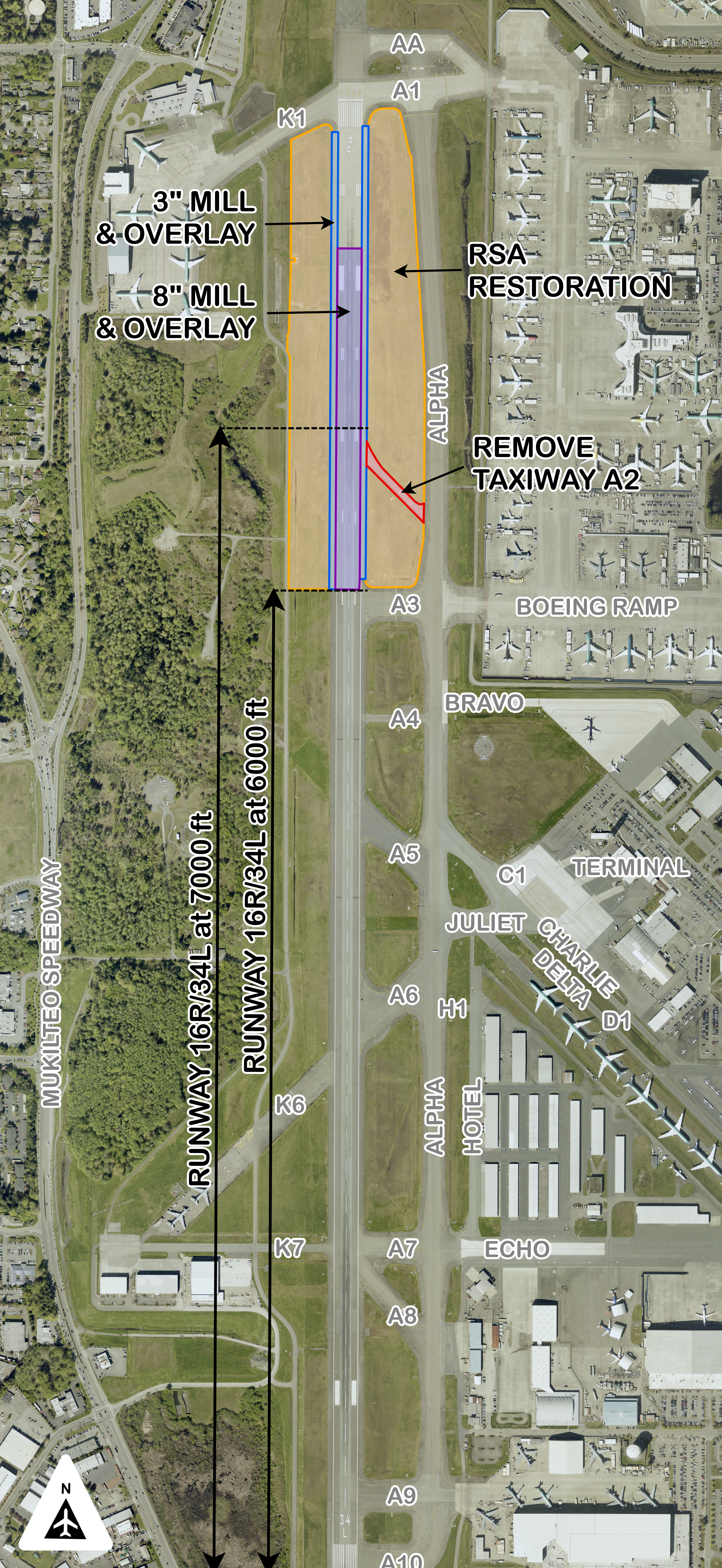

Map of Main Runway showing north 3,000 feet to be rehabilitated in 2026

Nightly closures

The main runway will be closed nightly from 11 PM to 7 AM from Jul. 7 through Oct. 31.

Additional Key Information for Main Runway Users

  • Extended runway closures:
    • From Jul. 7 at 11 PM to Jul. 10 at 7 AM
    • From Sep. 2 at 11 PM to Sep. 5 at 7 AM
    • From Oct. 28 at 11 PM to Oct. 31 at 7 AM
  • Runway length reduced to 6,000 feet:
    • Jul. 10 at 7 AM to Sep. 5 at 7 AM
  • Runway length increased to 7,000 feet:
    • Sep. 5 at 7 AM to Oct. 31 at 7 AM
  • Runway returns to full length
    • Oct. 31 at 7 AM

Runway grooving and final markings

The airport anticipates nightly closures from Dec. 1 through Dec. 15 to complete the runway grooving and final markings.

Taxilane Echo, Phase II

Reconstruction of Taxilane Echo to concrete was largely completed in 2025. Construction will resume in July 2026, rehabilitating Taxiway D2 and Taxiway L at the intersection with Taxiway G intersections. The areas to be completed are the purple, orange, and yellow sections, along with a small area of the light blue section on the eastern end.

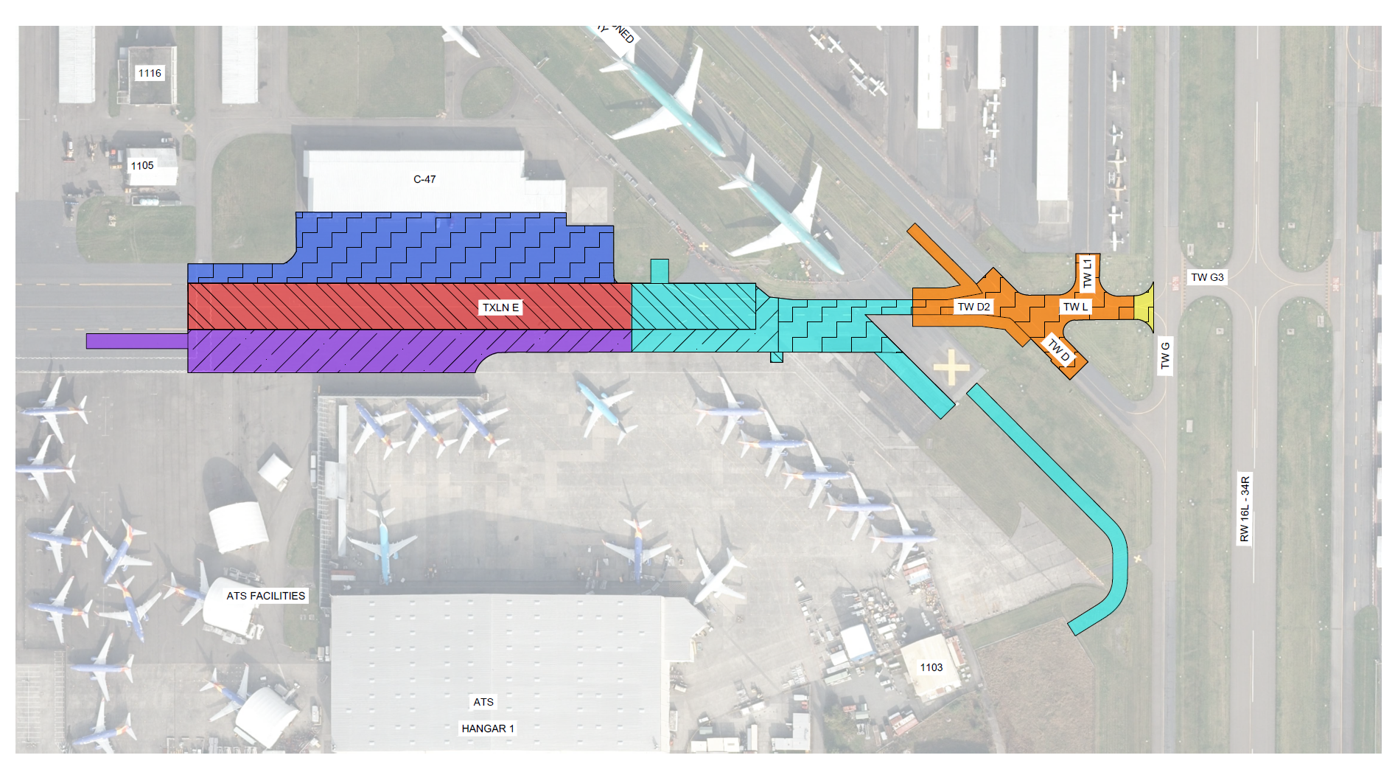

Taxilane Echo Phase 2 reconstruction
